Mott MacDonald Hong Kong Ltd. (“MMHK”) has been commissioned to undertake the Environmental Team (ET) services to carry out environmental monitoring and audit (EM&A) for both pre-construction and construction phases of the Proposed Comprehensive Development at Wo Shang Wai, Yuen Long.
This is the 151st EM&A report submitted under the Condition 4.5 of Environmental Permit No. EP-311/2008/E. This report summarises the findings on EM&A during the period from 1 to 30 November 2022.
Exceedance of Action and Limit Levels
There was no breach of Action or Limit levels for Air Quality (1-hr TSP and 24-hr TSP) and Noise level (as Leq) in the reporting month.
During November 2022, a total of four Action Level exceedances and three Limit Level exceedances for Water Quality were observed. Four Action Level exceedances of pH were recorded at MP3. Three Limit Level exceedances of DO were recorded at MP6.
Implementation of Mitigation Measures
Site audits were carried out on 4, 11, 16 and 24 November 2022 to confirm the implementation measures undertaken by the Contractor in the reporting month. The outcomes are presented in Section 6 and the status of implementation of mitigation measures in the site is shown in Appendix L.
Record of Complaints
There was no record of complaints received in the reporting month.
Future Key Issues
Site works scheduled to be commissioned in the coming three months include regular maintenance work for the Wetland Restoration Area including adjusting the water level, if required, and removal of unwanted species in the pond. No major construction works will be carried out. Potential environmental impacts due to the activities, including air quality, noise, water quality, ecology and landscape and visual, will be monitored.
Environmental mitigation measures will be
implemented on site as recommended and weekly site audits will be carried out
to ensure that the environmental conditions are acceptable.
In March 2005, the Project Proponent, Profit Point Enterprises Limited, acquired the development site at Wo Shang Wai in Yuen Long. An Environmental Impact Assessment (EIA) was then carried out and approved under the EIA Ordinance (EIAO), and the Environmental Permit (EP-311/2008) for construction of the comprehensive development in Wo Shang Wai was first granted by EPD on 9 September 2008 and has been subsequently varied, with the current version (EP-311/2008/E) issued by EPD on 19 December 2017.
The Project involves the residential development and associated infrastructure and wetland restoration area and linear landscape area. The construction works under the Environmental Permit commenced on 12 May 2010. The site formation construction works of the Wetland Restoration Area (hereafter WRA) were completed on 15 November 2010 and the WRA was established by October 2012, within 30 months from the commencement of construction as stipulated in the EP. This indicated that planting works as scheduled in the approved Wetland Restoration and Creation Scheme (WRCS; Nov 2009) were complete, except along the western and southern boundary where the planting is affected by the existing site boundary and noise barrier, and for which a Variation to Environmental Permit (EP-311/2008/C) to defer planting at the location was approved. Consequently, EP (EP-311/2008/D) including specific mitigation measures to minimise certain identified noise impacts during the operation phase was approved. The current valid EP (EP-311/2008/E) comprises varied conditions for the implementation and maintenance of visual and landscape measures, and for the implementation of noise mitigation measures.
Mott MacDonald Hong Kong Ltd. (“MMHK”) has been commissioned to undertake the Environmental Team (ET) services to carry out environmental monitoring and audit (EM&A) for both pre-construction and construction phases of the Proposed Comprehensive Development at Wo Shang Wai, Yuen Long.
According to the EP Condition 4.5, the monthly EM&A Report shall be submitted to the Director within two weeks after the end of the reporting month. This report summarises the findings during the period from 1 to 30 November 2022.
The organisation chart and lines of communication with respect to the on-site environmental management structure together with the contact information of the key personnel are shown in Appendix A.
During the reporting month, construction works of the Project undertaken include:
● General site maintenance work
● Regular maintenance work for the Wetland Restoration Area (including monitoring the water level and removal of unwanted species in the pond)
There were no major construction works carried out. The general layout plan of the Project site is shown in Figure 1.1.
The EM&A programme requires environmental monitoring of air quality, noise, water quality, ecology and landscape and visual as specified in the approved EM&A Manual.
A summary of impact EM&A requirements is presented in Table 1.1 below:
Table 1.1: Summary of Impact EM&A Requirements
Parameters |
Descriptions |
Locations |
Frequencies |
Air Quality |
24-Hour TSP |
ASR1, ASR2A, ASR3, ASR4 |
Once every 6 days |
1-Hour TSP |
ASR1, ASR2A, ASR3, ASR4 |
3 times every 6 days |
|
Noise |
Leq(30min), L90, L10 (dB(A)) |
NSR1, NSR3, NSR5, NSR7 |
Weekly |
Water Quality |
Dissolved Oxygen (DO), temperature, pH, suspended solids (SS) and Biochemical Oxygen Demand (BOD) |
MP1 to MP6 |
3 days per week |
Ecology |
Birds |
Within the Project Area and Assessment Area of 500m |
Weekly |
Dragonflies and Butterflies |
Within the Project Area and Assessment Area of 500m |
Once per month during Mar and Sep to Nov, and twice per month during Apr to Aug |
|
Herpetofauna |
Within the Project Area and Assessment Area of 500m |
Daytime: Once per month during Apr to Nov Night-time: Once per month during Mar to Aug |
|
Water quality of Wetland Restoration Area (WRA) |
WRA |
After filling of WRA with water, monthly for in situ water quality and every six months (end of wet season and end of dry season) for laboratory testing |
|
Site Inspections |
Within the Project Area and Assessment Area of 500m |
Weekly |
|
Landscape and Visual |
Auditing of protection of existing trees, the transplanting of existing trees, the creation of new wetland, the planting of new trees and shrubs and other landscape and visual mitigation measures |
CM1 to CM10 and OM1 to OM7 within the Project Area |
Site inspections once every two weeks during construction phase; once every two months during operational phase |
The Environmental Quality Performance Limits for air quality, noise and water quality are shown in Appendix C.
The Event and Action Plan for air quality, noise, water quality and Landscape & Visual are shown in Appendix D.

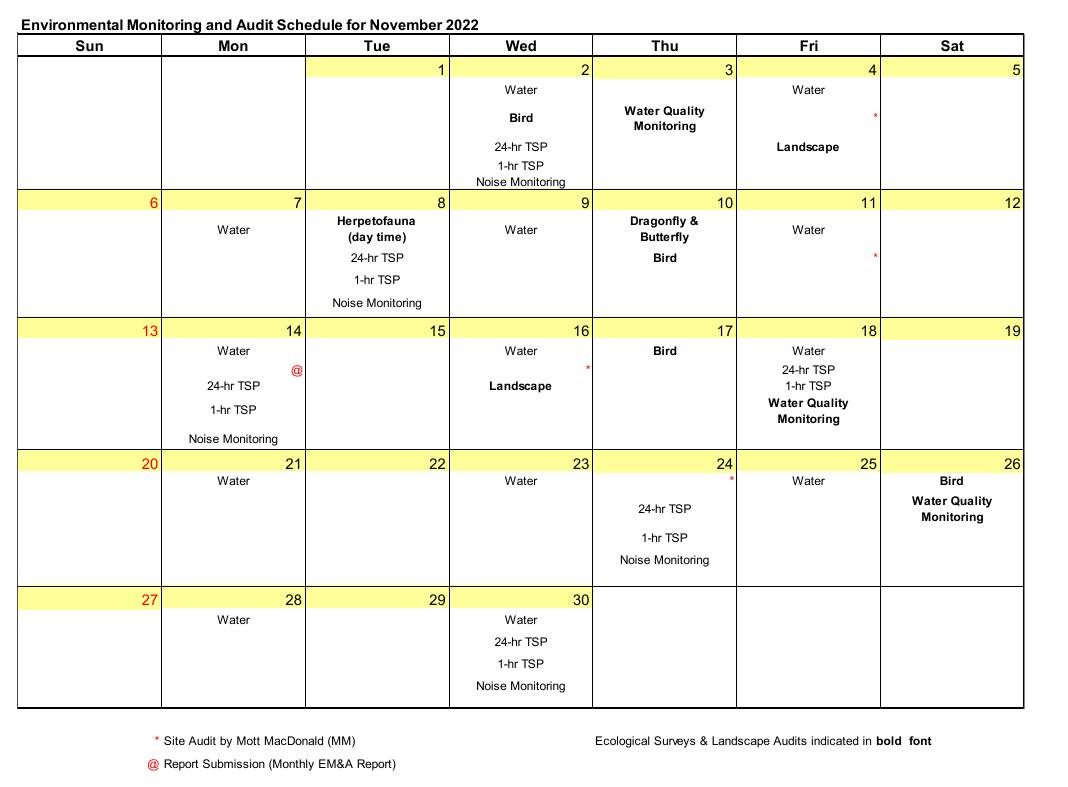

The monitoring schedule for the reporting month is shown in Table 1.2 as follows.
Table 1.2: Environmental Monitoring and Audit Schedule for the Reporting Month
For air quality, construction noise and water quality, ecology, landscape and visual monitoring methodology, including the monitoring locations, monitoring equipment used, monitoring parameters, and frequency and duration, etc., are detailed in this Chapter.
In accordance with the EM&A Manual, 1-hour and 24-hour TSP levels monitoring are to be conducted during the construction phase. Table 2.1 summarizes the monitoring parameters, frequency and duration of air quality monitoring.
Table 2.1: Air Quality Monitoring Parameters, Frequency and Duration
Monitoring Stations |
Parameter |
Frequency and Duration |
ASR1, ASR2A, ASR3 & ASR4 |
24-hour TSP |
At least once in every six-days |
1-hour TSP |
3 times every six-days |
The four air quality monitoring stations were established in the EM&A manual and were slightly adjusted during the baseline monitoring phase. Locations of the agreed air quality monitoring stations are listed in Table 2.2 and as shown in Figure 2.1.
Table 2.2: Air Monitoring Stations
Monitoring Stations |
Locations |
ASR1 |
Guard house outside House No. 1, Ventura Avenue, Royal Palms* |
ASR2A |
At the rooftop of refuse collection point, which is located at the southwest of the project area |
ASR3 |
At the commercial centre at Palm Springs, which is located at the south of the project area |
ASR4 |
Outside works site entrance* |
*Note: Relocation of ASR1 and ASR4 were from 5 June 2018 as the previous locations were within the Project construction site. All monitoring data at ASR1 and ASR4 from June 2018 is measured at the new monitoring locations.
Continuous 24-hour TSP air quality monitoring is conducted using High Volume Sampler (HVS) (Model: GMWS-2310 Accu-vol). The HVS meets all the requirements of the EM&A Manual. Portable direct reading dust meters were used to carry out the 1-hour TSP monitoring. Table 2.3 summarizes the equipment used in the impact air quality monitoring.
Table 2.3: TSP Monitoring Equipment
Equipment |
Model |
24-hr TSP monitoring |
|
High Volume Sampler |
GMWS 2310 Accu-vol |
Calibrator |
TE-5025A |
1-hr TSP monitoring |
|
Portable direct reading dust meter |
Sibata LD-3B
Laser Dust Monitor |
Installation
The HVS was installed in the vicinity of the air sensitive receiver. The following criteria were considered in the installation of the HVS.
● A horizontal platform with appropriate support to secure the sampler against gusty wind was provided.
● The distance between the HVS and any obstacles, such as buildings, was at least twice the height that the obstacle protrudes above the HVS.
● A minimum of two metres separation from walls, parapets and penthouse was required for rooftop sampler.
● A minimum of two metres separation from any supporting structure, measured horizontally was required.
● No furnace or incinerator flues or building vent were nearby.
● Airflow around the sampler was unrestricted.
● The sampler has been more than 20 metres from any drip line.
● Permission was obtained to set up the samplers and to obtain access to the monitoring stations.
● A secured supply of electricity is needed to operate the samplers.
Preparation of Filter Papers
● Glass fibre filters were labelled and sufficient filters that were clean and without pinholes were selected.
● All filters were equilibrated in the conditioning environment for 24 hours before weighing. The conditioning environment temperature was around 25 °C and not variable by more than ±3 °C with relative humidity (RH) < 50% and was not variable by more than ±5%. A convenient working RH was 40%.
Field Monitoring
● The power supply was checked to ensure the HVS works properly.
● The filter holder and the area surrounding the filter were cleaned.
● The filter holder was removed by loosening the four bolts and a new filter, with stamped number upward, on a supporting screen was aligned carefully.
● The filter was properly aligned on the screen so that the gasket formed an airtight seal on the outer edges of the filter.
● The swing bolts were fastened to hold the filter holder down to the frame. The pressure applied should be sufficient to avoid air leakage at the edges.
● The shelter lid was closed and was secured with the aluminium strip.
● The HVS was warmed-up for about 5 minutes to establish run-temperature conditions.
● A new flow rate record sheet was set into the flow recorder.
● The flow rate of the HVS was checked and adjusted at around 1.1 m3/min. The range specified in the EM&A Manual was between 0.6-1.7 m3/min.
● The programmable timer was set for a sampling period of 24 hrs + 1 hr, and the starting time, weather condition and the filter number were recorded.
● The initial elapsed time was recorded.
● At the end of sampling, the sampled filter was removed carefully and folded in half-length so that only surfaces with collected particulate matter were in contact.
● It was then placed in a clean plastic envelope and sealed.
● All monitoring information was recorded on a standard data sheet.
● Filters were sent to a HOKLAS accredited laboratory for analysis.
Maintenance and Calibration
● The HVS and its accessories are maintained in good working condition, such as replacing motor brushes routinely and checking electrical wiring to ensure a continuous power supply.
● HVSs were calibrated at two-month intervals.
● Calibration records for HVSs are shown in Appendix E.
Field Monitoring
The measuring procedures of the 1-hour dust meter are in accordance with the Manufacturer’s Instruction Manual as follows:
● Set POWER to “ON”, push BATTERY button, make sure that the meter’s indicator is in the range with a red line and allow the instrument to stand for about 3 minutes (Then, the air sampling inlet has been capped).
● Push the knob at MEASURE position.
● Push “O-ADJ” button. (Then meter’s indication is 0).
● Push the knob at SENSI ADJ position and set the meter’s indication to S value described on the Test Report using the trimmer for SENSI ADJ.
● Pull out the knob and return it to MEASURE position.
● Push “START” button.
Maintenance and Calibration
● The 1-hour dust meter would be checked at 3-month intervals and calibrated at 1-year intervals throughout all stages of the air quality monitoring.
● Calibration records for direct dust meters are shown in Appendix E.
Following the requirements in the EM&A Manual for noise, noise monitoring has to be carried out during the construction phase. Continuous noise monitoring for the A-weighted levels Leq(30 min), L10 and L90 is undertaken once per every week.
Table 2.4 summarizes the monitoring parameters, frequency and duration of air quality monitoring.
Table 2.4: Noise Monitoring Parameters, Frequency and Duration
Monitoring Stations |
Parameter |
Frequency and Duration |
NSR1, NSR3, NSR5, NSR7 |
Leq(30min), L90, L10 (dB(A)) |
Once every week |
The four noise quality monitoring stations were established in the EM&A manual and were slightly adjusted during the baseline monitoring phase. Locations of the agreed noise quality monitoring stations are listed in Table 2.5 and as shown in Figure 2.2.
Table 2.5: Noise Monitoring Stations
Monitoring Stations |
Locations |
Type of measurement |
NSR1 |
Noise monitoring equipment was set up near the boundary wall at Palm Springs |
Free field |
NSR3 |
The monitoring station was located next to the guard house at Palm Spring |
Façade |
NSR5 |
Outside House No. 1, Ventura Avenue, Royal Palms* |
Façade |
NSR7 |
The monitoring station was located near the boundary wall of the house of Mai Po San Tsuen |
Free field |
*Note: Relocation of NSR5 was from 5 June 2018 as the previous location was within the Project construction site. All monitoring data at NSR5 from June 2018 is measured at the new monitoring location.
Integrating Sound Level Meter was used for noise monitoring. It is a Type 1 sound level meter capable of giving a continuous readout of the noise level readings including equivalent continuous sound pressure level (Leq) and percentile sound pressure level (Lx). They comply with International Electrotechnical Commission Publications 651:1979 (Type 1) and 804:1985 (Type 1). Table 2.6 summarizes the noise monitoring equipment model being used.
Table 2.6: Noise Monitoring Equipment
Equipment |
Model |
Integrating Sound Level Meter |
Rion NL-52 |
Calibrator |
Larson Davis CAL200 |
Field Monitoring
● The Sound Level Meter was set on a tripod at a height of at least 1.2 m above the ground.
● Façade and free-field measurements were made at the monitoring locations.
● The battery condition was checked to ensure the correct functioning of the meter.
● Parameters such as frequency weighting, the time weighting and the measurement time were set as follows:
– frequency weighting: A
– time weighting: Fast
– time measurement: 30 minutes intervals (between 07:00 and 19:00)
● Prior to and after each noise measurement, the meter was calibrated using a Calibrator for 94 dB at 1 kHz. If the difference in the calibration level before and after measurement was more than 1 dB, the measurement would be considered invalid has to be repeated after re-calibration or repair of the equipment.
● During the monitoring period, the Leq, L10 and L90 were recorded. In addition, any site observations and noise sources were recorded on a standard record sheet.
Maintenance and Calibration
● The microphone head of the sound level meter and calibrator is cleaned with soft cloth at quarterly intervals.
● The meter and calibrator are sent to the supplier or HOKLAS laboratory to check and calibrate at yearly intervals.
● Calibration records are shown in Appendix E.
In accordance with the requirements in the EM&A Manual for water quality, water quality parameters including Dissolved Oxygen (DO), temperature, pH, turbidity, suspended solids (SS) and Biochemical Oxygen Demand (BOD) have to be monitored at designated monitoring stations during construction of the Project. DO, temperature and pH were measured in-situ whereas SS and BOD were analysed in a laboratory. The measurements should be taken at all designated monitoring stations, three days per week. The interval between any two sets of monitoring was not less than 36 hours. Table 2.7 summarizes the monitoring parameters, frequency and duration of water quality monitoring.
Table 2.7: Water Quality Monitoring Parameters, Frequency and Duration
Monitoring Stations |
Parameter |
Frequency and Duration |
MP1, MP2, MP3, MP4, MP5 & MP6 |
DO, temperature, pH, SS, turbidity, BOD |
Three days every week |
The six water quality monitoring stations were established in the EM&A manual. Locations of the agreed water quality monitoring stations are listed in Table 2.8 and as shown in Figure 2.3.
Table 2.8: Water Quality Monitoring Stations
Monitoring Stations |
Easting |
Northing |
MP1* |
838 730.50 |
822 862.25 |
MP2* |
838 933.26 |
823 247.41 |
MP3 |
839 107.17 |
823 596.84 |
MP4 |
839 286.14 |
823 638.55 |
MP5 |
839 134.35 |
823 722.99 |
MP6 |
839 063.02 |
823 842.25 |
*Note: The water quality impact monitoring at MP1 and MP2 have been terminated since July 2012 due to withdrawal of access right from landowner.
The Water Quality Monitoring Equipment and Analytical Methods applied to Water Quality Samples are given in Table 2.9 and Table 2.10 respectively. Details of which are discussed as follows.
Table 2.9: Water Quality Monitoring Equipment
Equipment |
Model |
Equipment/ Serial Number |
Conductivity, Dissolved oxygen, pH, Salinity and Temperature Measuring Meter, Turbidity |
YSI ProDSS |
17E10074716H104234 |
Global Positioning System (GPS) |
Garmin eTrex Vista |
ENO 007 |
Table 2.10: Analytical Methods applied to Water Quality Samples
Determinant, unit |
Standard Method |
Total Suspended Solids, mg/L |
In house method based on APHA 2540D; ALS Method Code: EA-025 |
Biochemical Oxygen Demand (BOD), mg/L |
In house method based on APHA 5210B; ALS Method Code: EP-030 |
All in-situ monitoring instruments were checked, calibrated and certified by a laboratory accredited under HOKLAS or any other international accreditation scheme before use.
Dissolved Oxygen (DO), Temperature, pH and Turbidity measuring equipment
A portable, weatherproof multiparameter instrument (YSL ProDSS) was used in the monitoring. It can be capable for measuring dissolved oxygen (DO), temperature, pH and turbidity simultaneously with the following limits:
● a dissolved oxygen level in the range of 0-50 mg/L and 0-500 % saturation;
● a temperature of -5 to 70 degrees Celsius;
● pH value of 0-14 with 0.1 as the base unit; and
● turbidity between 0-4000 NTU
Global Positioning System (GPS)
A hand-held GPS navigator (Garmin eTrex Vista) was used to identify the designated monitoring stations prior to water sampling.
Suspended Solids and BOD Measurements (Sample Containers and Storage)
Water samples for SS analysis were stored in high density polythene bottles with no preservative added, packed in ice (cooled to 4 ºC without being frozen), delivered to the laboratory, and analysed as soon as possible after collection. Analysis was carried out in a HOKLAS accredited laboratory.
The limits of detection for the in-situ and laboratory measurements are shown in Table 2.11.
Table 2.11: Detection Limits for Water Quality Determinants
Determinant |
Limit of Detection |
Dissolved Oxygen |
0.1 mg/L |
Temperature |
0.1 degree Celsius |
pH |
0.01 unit |
Turbidity |
0.1 NTU |
Suspended Solids |
2 mg/L |
BOD |
2 mg/L |
In situ Measurement
All pH meters, DO/ temperature meters had been checked and calibrated prior to use. Standard buffer solution of at least two pH levels (either pH 4 and pH 7, or pH 7 and pH 10) had been used for calibration of the instrument before and after use.
DO meters had been calibrated by a laboratory accredited under HOKLAS or any other international accreditation scheme, and subsequently re-calibrated at three-monthly intervals throughout all stages of the water quality monitoring. Responses of sensors and electrodes had been checked with certified standard solutions before each use. Wet bulb calibrations for all DO meters had been carried out before measurement at each monitoring location. For the on-site calibration of field equipment, BS 1427:2009, "Guide to on-site test methods for the analysis of waters" had been observed.
Measurements were taken at three water depths, namely, 1m below water surface, mid-depth and 1m above stream bed/pond bed, except where the water depth is less that 6m, the mid-depth station maybe omitted. Should the water depth be less than 3 m, only the mid-depth station will be monitored.
Replicates in-situ measurements and samples collected from each independent monitoring event are required for all parameters to ensure a robust statistically interpretable dataset.
Water Samples Preparation and Analysis
For collection of water sampling within the water courses, a 500ml clean plastic beaker was used. After collection, the water samples were stored in high-density polythene bottles. The sample container was rinsed with a portion of the water sample. The water sample was then transferred to the container, labelled with a unique sample ID and sealed with a screw cap. The water samples were stored in a cool box maintained at 4 ºC. The water samples were then delivered to a local HOKLAS-accredited laboratory (ALS) on the same day for analysis.
The testing methods of testing parameters as recommended by EIA or required by EPD, with the QA/QC results are in accordance with the requirement of HOKLAS or international accredited scheme.
The calibration certificates for equipment used for in-situ monitoring of water quality are attached in Appendix E.
Target species and certain other fauna were monitored within the Project Area and Assessment Area during the wetland and residential construction phase. This is important to ensure that any unexpected events or impacts either on- or off-site are quickly identified so that remedial action can be taken. The groups monitored and frequency of monitoring are shown in Table 2.12.
Table 2.12: Summary of Construction Phase Ecological Monitoring for the Wo Shang Wai Wetland Restoration Area (WRA)
Species / Parameter |
Construction Phase Ecological Monitoring |
Birds |
Weekly (including Assessment Area) |
Dragonflies and Butterflies |
Once per month during March and September to November; and twice per month during April to August |
Herpetofauna |
Daytime: Once per month during April to November; and Night-time: Once per month during March to August |
Water Quality |
After filling of WRA with water, monthly for in situ water quality and every six months (end of the wet season and end of the dry season) for laboratory testing |
Site Inspections |
Weekly |
Ecological monitoring locations during construction phase are shown in Figure 4.1 and the methodology for ecological monitoring is detailed in Section 4.
All measures undertaken by both the Contractor and the specialist Landscape Sub-Contractor during the construction phase and first year of the operational phase shall be audited by a Registered Landscape Architect, as a member of the ET, on a regular basis to ensure compliance with the intended aims of the measures. Site inspections should be undertaken at least once every two weeks throughout the construction period and once every two months during the operational phase.
The broad scope of audit is detailed below but should also be undertaken with reference to the more specific checklist provided in Table 2.13 below. Operational phase auditing will be restricted to the last 12 months of the establishment works of the landscaping proposals and thus only the items below concerning this period are relevant to the operational phase.
● The extent of the agreed works area should be regularly checked during the construction phase. Any trespass by the Contractor outside the limit of the works, including any damage to existing trees and woodland shall be noted;
● The progress of the engineering works should be regularly reviewed on site to identify the earliest practical opportunities for the landscape works to be undertaken;
● All existing vegetation, streams and other features within the study area which are not directly affected by the works are retained and protected;
● The methods of protecting existing vegetation proposed by the Contractor are acceptable and enforced;
● Preparation, lifting transport and re-planting operations for any transplanted trees;
● The layout, design and construction of buildings conforms to requirements specified in the EIA report;
● All landscaping works are carried out in accordance with the EIA recommendations and with specifications;
● The planting of new trees, shrubs, groundcover, climbers, grasses and other plans, together with the replanting of any transplanted trees are carried out properly and within the right season;
● All necessary horticultural operations and replacement planting are undertaken throughout the Establishment Period to ensure the healthy establishment and growth of both transplanted trees and all newly establishment plants.
Table 2.13: Construction and Operation Phase Audit Checklist
Area of Works |
Items to be Monitored |
Works Area |
Check the extent of the Works to ensure that the Works Area is not exceeded the site boundaries. |
Protection of all trees and woodland blocks to be retained |
Identification and demarcation of trees / vegetation to be retained, erection of physical protection (e.g. fencing), monitoring against possible incursion, physical damage, fire, pollution, surface erosion, etc. |
Streams |
Ensure no run-off into existing streams |
Clearance of existing vegetation |
Identification and demarcation of trees / vegetation to be cleared, checking of extent of works to minimize damage, monitoring of adjacent areas against possible incursion, physical damage, fire, pollution, surface erosion, etc. |
Transplanting of trees |
Identification and demarcation of trees / vegetation to be transplanted, monitoring of extent of pruning / lifting works to minimize damage, timing of operations implementation of all stages of preparatory and translocation works, and maintenance of transplanted vegetation, etc. |
Topsoil stripping |
Ensuring existing topsoil is stripped and stored under recognized good practice and is hydroseeded and regularly turned to prevent anaerobic conditions |
New buildings |
Ensure that building finishes accord with mitigation proposals with regard to colour and albedo. |
Boundaries |
Ensuring hoarding are erected as required |
Noise Barrier |
Ensure noise barrier design accords with the mitigation proposals with regard to location, materials and finishes. |
Night-time lighting |
Ensuring night-time lighting is directional, hooded and shielded away from VSRs |
Plant supply |
Monitoring of operations relating to the supply of specialist plant material (including the collecting, germination and growth of plants from seed) to ensure that plants will be available in time to be used within the construction works. |
Landscape and wetland treatments generally |
Check that wetland, and hard / soft landscape designs conform to intent of mitigation measures and agreed designs |
Soiling, planting, etc. |
Monitoring of implementation and maintenance of soiling and planting works against possible incursion, physical damage, fire, pollution, surface erosion, etc. |
Establishment Works |
Monitoring of implementation of maintenance operation during Establishment Period |
The monitoring locations should check against the mitigation measures proposed under the approved Environmental Impact Assessment, which are summarised as follows in Table 2.14 and Table 2.15:
Table 2.14: Proposed Construction Phase Mitigation Measures
ID No. |
Landscape and Visual Mitigation Measures |
CM1 |
The construction area and contractor’s temporary works areas should be minimised to avoid impacts on adjacent landscape. |
CM2 |
Screening of construction works by hoardings/noise barriers around Works area in visually unobtrusive colours, to screen Works. |
CM3 |
Reduction of construction period to practical minimum. |
CM4 |
Topsoil, where identified, should be stripped and stored for re-use in the construction of the soft landscape works, where the soil material meets acceptable criteria and where practical. The Contract Specification shall include storage and reuse of topsoil as appropriate. |
CM5 |
Hydroseeding or sheeting of soil stockpiles with visually unobtrusive material (in earth tone). |
CM6 |
Advance screen planting of noise barriers. |
CM7 |
Control night-time lighting and glare by hooding all lights. |
CM8 |
Ensure no run-off into streams adjacent to Project Area. |
CM9 |
Protection of existing trees on boundary of project area shall be carefully protected during construction. Detailed Tree Protection Specification shall be provided in the Contract Specification. Under this specification, the Contractor shall be required to submit, for approval, a detailed working method statement for the protection of trees prior to undertaking any works adjacent to all retained trees, including trees in contractor’s works areas. (Tree protection measures will be detailed at S16 and Tree Removal Application stage). |
CM10 |
Trees unavoidably affected by the works shall be transplanted where practical. Trees should be transplanted straight to their destinations and not held in a nursery. A detailed Tree Transplanting Specification shall be provided in the Contract Specification, if applicable. Sufficient time for necessary tree root and crown preparation periods shall be allowed in the project programme. |
Table 2.15: Proposed Operation Phase Mitigation Measures
ID No. |
Landscape Mitigation Measures |
OM1 |
Compensatory Tree Planting for all felled trees shall be provided to the satisfaction of relevant Government departments. Required numbers and locations of compensatory trees shall be determined and agreed separately with Government during the Tree Felling Application process under DEVB TC(W) 7/2015. |
OM2 |
A continuous belt of screen planting along southern perimeter of project area with fast growing tree species. At least 450 trees capable of reaching a height > 10m within 10 years should be planted. Planting of the belt of trees shall be carried out as advance works ahead of other site formation and building works. |
OM3 |
Maximise soft landscape and amenity water bodies in residential areas of the development. Approximately 750 trees (of Heavy Standard size) should be planted. Where space permits, roadside berms should be created. Street trees should be of species that reach a mature height of no less than 15m. |
OM4 |
Maximise freshwater habitat wetland creation consistent with achieving other parameters. Minimum 4.74 ha to be provided. Wetlands must have natural edge profiles with >1m wide emergent zone. No access to the wetland by residents and all wetlands must be screened from residential development by a continuous tree screen at interface with residential development or earth mounding such that disturbance is minimised. Implementation of the wetland shall be carried out as advance works. |
OM5 |
Use appropriate (visually unobtrusive and non-reflective) building materials and colours in built structures. |
OM6 |
During detailed design, refine building layout to create a min. 10m wide gap between buildings north of Wo Shang Wai pond and also two min. 10m wide gaps in the row of buildings adjacent to Royal Palms. |
OM7 |
Streetscape elements (e.g. paving, signage, street furniture, lighting etc.) shall be sensitively designed in a manner that responds to the local context and minimises potential negative landscape and visual impacts. Lighting units should be directional and minimise unnecessary light spill. |
Impact monitoring for air quality (dust), noise and water quality due to the construction work were undertaken during the reporting month in compliance with the EM&A manual in the reporting period. Regular site inspections were carried out on 4, 11, 16 and 24 November 2022 during the reporting month to assess the compliance with environmental requirements.
Results of 1-hour TSP at the four monitoring locations are summarised in Table 3.1. Graphical plots of the monitoring results are shown in Appendix F. The weather conditions in the reporting period are provided in Appendix G.
Table 3.1: Summary of 1-hour TSP Monitoring Results
Monitoring Date |
Start Time |
1-hr TSP (mg/m3) |
Range (mg/m3) |
Action Level (mg/m3) |
Limit Level (mg/m3) |
||
1st Result |
2nd Result |
3rd Result |
|||||
ASR1 |
|
|
|
|
|
|
|
02-Nov-22 |
07:36 |
21 |
22 |
22 |
17-30 |
378 |
500 |
08-Nov-22 |
08:46 |
22 |
23 |
23 |
|||
14-Nov-22 |
08:32 |
20 |
17 |
17 |
|||
18-Nov-22 |
09:05 |
24 |
25 |
24 |
|||
24-Nov-22 |
08:32 |
24 |
23 |
23 |
|||
30-Nov-22 |
08:30 |
30 |
22 |
21 |
|||
ASR2A |
|
|
|
|
|
|
|
02-Nov-22 |
11:32 |
27 |
29 |
26 |
17-29 |
357 |
500 |
08-Nov-22 |
12:56 |
24 |
24 |
25 |
|||
14-Nov-22 |
13:07 |
21 |
20 |
18 |
|||
18-Nov-22 |
13:17 |
22 |
20 |
20 |
|||
24-Nov-22 |
13:03 |
19 |
17 |
17 |
|||
30-Nov-22 |
13:14 |
25 |
19 |
20 |
|||
ASR3 |
|
|
|
|
|
|
|
02-Nov-22 |
11:51 |
24 |
25 |
25 |
18-27 |
358 |
500 |
08-Nov-22 |
13:15 |
21 |
23 |
21 |
|||
14-Nov-22 |
13:26 |
18 |
18 |
19 |
|||
18-Nov-22 |
13:02 |
19 |
19 |
22 |
|||
24-Nov-22 |
13:18 |
22 |
20 |
27 |
|||
30-Nov-22 |
13:31 |
24 |
27 |
25 |
ASR4 |
|
|
|
|
|
|
|
02-Nov-22 |
07:55 |
22 |
20 |
19 |
16-27 |
372 |
500 |
08-Nov-22 |
09:03 |
20 |
24 |
25 |
|||
14-Nov-22 |
08:52 |
19 |
16 |
17 |
|||
18-Nov-22 |
08:48 |
21 |
26 |
20 |
|||
24-Nov-22 |
08:49 |
26 |
22 |
21 |
|||
30-Nov-22 |
08:49 |
27 |
22 |
18 |
Results of 24-hour TSP at the four monitoring locations are summarised in Table 3.2. Graphical plots of the monitoring results are shown in Appendix F. The weather conditions in the reporting period are provided in Appendix G.
Table 3.2: Summary of 24-hour TSP Monitoring Results
Monitoring Date |
Monitoring Results (mg/m3) |
Range (mg/m3) |
Action Level (mg/m3) |
Limit Level (mg/m3) |
ASR1 |
|
|
|
|
02-Nov-22 |
17 |
17-65 |
226 |
260 |
08-Nov-22 |
41 |
|||
14-Nov-22 |
50 |
|||
18-Nov-22 |
65 |
|||
24-Nov-22 |
22 |
|||
30-Nov-22 |
61 |
|||
ASR2A |
|
|
|
|
02-Nov-22 |
15 |
15-70
|
213 |
260 |
08-Nov-22 |
41 |
|||
14-Nov-22 |
48 |
|||
18-Nov-22 |
70 |
|||
24-Nov-22 |
21 |
|||
30-Nov-22 |
39 |
|||
ASR3 |
|
|
|
|
02-Nov-22 |
20 |
20-75 |
205 |
260 |
08-Nov-22 |
53 |
|||
14-Nov-22 |
60 |
|||
18-Nov-22 |
75 |
|||
24-Nov-22 |
24 |
|||
30-Nov-22 |
52 |
|||
ASR4 |
|
|
|
|
02-Nov-22 |
16 |
16-56
|
237
|
260
|
08-Nov-22 |
51 |
|||
14-Nov-22 |
52 |
|||
18-Nov-22 |
56 |
|||
24-Nov-22 |
22 |
|||
30-Nov-22 |
51 |
No exceedance of 1-hour and 24-hour TSP (Action or Limit Level) was recorded in the reporting period.
The construction noise monitoring results are summarized in Table 3.3. Graphical plots of the monitoring data are shown in Appendix F. The weather conditions in the reporting period are provided in Appendix G.
Table 3.3: Summary of Construction Noise Monitoring Results
Monitoring Date |
Start Time |
Mean and Range of Noise Levels, dB(A) |
Limit Level for Leq (dB(A)) |
||
Leq |
L10 |
L90 |
|||
NSR1 |
|
|
|
|
|
02-Nov-22 |
11:24 |
50 |
52 |
42 |
75 |
08-Nov-22 |
11:28 |
49 |
50 |
40 |
|
14-Nov-22 |
11:22 |
51 |
53 |
41 |
|
24-Nov-22 |
11:24 |
50 |
52 |
41 |
|
30-Nov-22 |
11:12 |
46 |
48 |
41 |
|
NSR3 |
|
|
|
|
|
02-Nov-22 |
10:35 |
47 |
48 |
41 |
75 |
08-Nov-22 |
10:41 |
42 |
43 |
38 |
|
14-Nov-22 |
10:32 |
42 |
44 |
40 |
|
24-Nov-22 |
10:34 |
46 |
48 |
42 |
|
30-Nov-22 |
10:28 |
44 |
45 |
41 |
|
NSR5 |
|
|
|
|
|
02-Nov-22 |
09:47 |
49 |
52 |
46 |
75 |
08-Nov-22 |
09:55 |
47 |
50 |
44 |
|
14-Nov-22 |
09:44 |
47 |
48 |
44 |
|
24-Nov-22 |
09:45 |
51 |
52 |
47 |
|
30-Nov-22 |
09:40 |
49 |
51 |
44 |
|
NSR7 |
|
|
|
|
|
02-Nov-22 |
09:00 |
67 |
69 |
64 |
75 |
08-Nov-22 |
09:07 |
67 |
69 |
64 |
|
14-Nov-22 |
08:54 |
66 |
68 |
63 |
|
24-Nov-22 |
08:57 |
67 |
69 |
63 |
|
30-Nov-22 |
08:51 |
67 |
68 |
64 |
No exceedance (Action/Limit Level) of construction noise was recorded in the reporting period.
The water quality monitoring results are summarized in Table 3.4. Graphical plots of the monitoring data are shown in Appendix F. The weather conditions in the reporting period are provided in Appendix G.
Table 3.4: Summary of Water Quality Monitoring Results
Monitoring Date |
Temp (ºC) |
pH |
Dissolved Oxygen (DO) (mg/L) |
DO (%) |
Turbidity (NTU) |
BOD (mg/L)(1) |
Suspended Solids (mg/L) |
MP3 |
|
|
|
|
|
|
|
02/11/2022 |
25.7 |
7.7 |
7.4 |
91.4 |
40.3 |
4 |
43 |
04/11/2022 |
27.0 |
7.6 |
7.8 |
97.0 |
10.3 |
3 |
7 |
07/11/2022 |
27.7 |
7.7 |
7.6 |
97.4 |
8.1 |
3 |
8 |
09/11/2022 |
27.8 |
7.6 |
7.7 |
97.7 |
40.3 |
<2 |
41 |
11/11/2022 |
28.1 |
7.5 |
7.8 |
99.9 |
12.3 |
5 |
12 |
14/11/2022 |
25.8 |
7.2 |
7.3 |
89.9 |
19.3 |
6 |
18 |
16/11/2022 |
25.0 |
7.3 |
7.0 |
85.1 |
23.7 |
7 |
22 |
18/11/2022 |
24.6 |
7.2 |
6.9 |
84.0 |
27.9 |
6 |
23 |
21/11/2022 |
25.6 |
7.2 |
7.0 |
86.3 |
22.2 |
4 |
18 |
23/11/2022 |
24.2 |
7.3 |
7.2 |
86.0 |
30.2 |
4 |
27 |
25/11/2022 |
25.2 |
7.4 |
7.1 |
86.5 |
29.8 |
5 |
30 |
28/11/2022 |
18.6 |
7.2 |
7.5 |
80.5 |
24.5 |
5 |
17 |
30/11/2022 |
17.4 |
7.4 |
7.6 |
79.5 |
25.4 |
7 |
22 |
Action Level |
- |
<5.5 or >7.5 |
<6.85 |
- |
>64 |
- |
>65 |
Limit Level |
- |
<4.0 or >8.0 |
<6.65 |
- |
>67 |
- |
>66 |
|
|
|
|
|
|
|
|
MP4 |
|
|
|
|
|
|
|
02/11/2022 |
25.3 |
7.3 |
5.5 |
49.0 |
23.1 |
3 |
22 |
04/11/2022 |
26.6 |
7.4 |
5.4 |
64.7 |
17.2 |
3 |
17 |
07/11/2022 |
27.3 |
7.5 |
5.0 |
61.9 |
24.2 |
2 |
22 |
09/11/2022 |
27.5 |
7.5 |
5.3 |
67.4 |
25.9 |
2 |
19 |
11/11/2022 |
27.9 |
7.4 |
5.5 |
70.2 |
12.8 |
3 |
15 |
14/11/2022 |
25.4 |
7.0 |
5.0 |
61.6 |
12.5 |
<2 |
12 |
16/11/2022 |
24.8 |
7.0 |
4.9 |
59.3 |
25.2 |
<2 |
27 |
18/11/2022 |
22.8 |
7.0 |
5.0 |
58.4 |
20.0 |
3 |
20 |
21/11/2022 |
24.9 |
7.0 |
5.2 |
63.4 |
39.6 |
<2 |
36 |
23/11/2022 |
23.7 |
7.0 |
5.3 |
63.5 |
19.0 |
<2 |
17 |
25/11/2022 |
24.9 |
7.0 |
5.2 |
63.1 |
23.0 |
<2 |
23 |
28/11/2022 |
18.8 |
6.9 |
5.5 |
59.0 |
17.0 |
<2 |
12 |
30/11/2022 |
17.2 |
7.1 |
5.8 |
60.0 |
15.1 |
<2 |
13 |
Action Level |
- |
<5.5 or >7.5 |
<3.91 |
- |
>60 |
- |
>50 |
Limit Level |
- |
<4.0 or >8.0 |
<3.82 |
- |
>64 |
- |
>53 |
|
|
|
|
|
|
|
|
MP5 |
|
|
|
|
|
|
|
02/11/2022 |
25.9 |
7.4 |
5.0 |
50.8 |
22.5 |
3 |
24 |
04/11/2022 |
27.2 |
7.2 |
4.9 |
55.1 |
18.5 |
3 |
20 |
07/11/2022 |
27.9 |
7.4 |
4.8 |
57.0 |
26.4 |
<2 |
23 |
09/11/2022 |
28.0 |
7.3 |
5.1 |
65.2 |
26.4 |
<2 |
22 |
11/11/2022 |
28.4 |
7.4 |
5.2 |
67.3 |
37.1 |
2 |
45 |
14/11/2022 |
26.0 |
6.9 |
4.6 |
57.2 |
16.1 |
<2 |
17 |
16/11/2022 |
25.3 |
6.8 |
4.4 |
54.0 |
29.1 |
2 |
33 |
18/11/2022 |
24.7 |
6.8 |
4.6 |
55.5 |
26.2 |
3 |
22 |
21/11/2022 |
25.8 |
6.9 |
5.0 |
61.9 |
45.1 |
<2 |
38 |
23/11/2022 |
24.6 |
6.8 |
5.1 |
61.1 |
20.8 |
<2 |
18 |
25/11/2022 |
25.5 |
6.8 |
5.0 |
61.2 |
24.7 |
3 |
24 |
28/11/2022 |
19.1 |
6.8 |
5.1 |
55.4 |
17.3 |
<2 |
12 |
30/11/2022 |
17.1 |
7.0 |
5.3 |
55.2 |
17.2 |
<2 |
15 |
Action Level |
- |
<5.5 or >7.5 |
<4.13 |
- |
>81 |
- |
>66 |
Limit Level |
- |
<4.0 or >8.0 |
<3.87 |
- |
>84 |
- |
>69 |
|
|
|
|
|
|
|
|
MP6 |
|
|
|
|
|
|
|
02/11/2022 |
26.2 |
7.3 |
4.9 |
46.0 |
26.3 |
2 |
27 |
04/11/2022 |
27.5 |
7.2 |
4.8 |
50.5 |
17.9 |
3 |
16 |
07/11/2022 |
28.2 |
7.4 |
4.9 |
55.5 |
27.6 |
3 |
24 |
09/11/2022 |
28.1 |
7.2 |
5.0 |
64.0 |
26.6 |
2 |
22 |
11/11/2022 |
28.5 |
7.2 |
5.0 |
65.6 |
34.5 |
3 |
57 |
14/11/2022 |
26.1 |
6.9 |
4.5 |
55.1 |
21.3 |
2 |
29 |
16/11/2022 |
25.5 |
6.8 |
4.3 |
51.9 |
30.0 |
<2 |
33 |
18/11/2022 |
24.7 |
6.8 |
4.4 |
53.1 |
26.9 |
4 |
49 |
21/11/2022 |
25.9 |
6.9 |
4.9 |
59.9 |
41.5 |
<2 |
36 |
23/11/2022 |
24.7 |
6.8 |
5.0 |
59.8 |
19.8 |
<2 |
17 |
25/11/2022 |
25.6 |
6.8 |
5.0 |
59.7 |
28.1 |
2 |
35 |
28/11/2022 |
19.2 |
6.8 |
5.0 |
53.9 |
18.5 |
<2 |
14 |
30/11/2022 |
17.5 |
6.9 |
5.1 |
53.1 |
18.6 |
<2 |
21 |
Action Level |
- |
<5.5 or >7.5 |
<4.61 |
- |
>94 |
- |
>75 |
Limit Level |
- |
<4.0 or >8.0 |
<4.52 |
- |
>96 |
- |
>75 |
Notes:
(1) “<2”: Value is too low to indicate (<2mg/L).
(2) For the Limit Level of DO, 1-percentile of baseline data is adopted as it is greater than 2mg/L. (Refer to Baseline Monitoring Report)
(3) Values in Bold indicate Action Level exceedance.
(4) Values Underlined and in Bold indicate Limit Level exceedance.
During November 2022, a total of four Action Level exceedances and three Limit Level exceedances for Water Quality were observed. Four Action Level exceedances of pH were recorded at MP3. Three Limit Level exceedances of DO were recorded at MP6.
Exceedance of pH at MP3
Exceedances of the Action Level of pH were observed on 2, 4, 7 and 9 November 2022 at MP3. As understood, the fish pond near the site (represented by MP3) is separated from the open ditch by the pond bund (since commencement of construction phase EM&A monitoring in May 2010) and from the construction site by the WRA (since it was completed in November 2010). No direct discharge from the project site to the fish pond was observed.
Mitigation measures for water quality protection, including the provision of wastewater treatment facilities (with sedimentation tank and AquaSed) and proper drainage system that separates from the WRA, have been implemented. No adverse impact on the fish pond near the site was observed, including on the day with exceedance of water quality parameters.
According to the results of the baseline water quality monitoring conducted prior to the commencement of construction works, the pH recorded at MP3 ranged from 7.7 to 8.6. The recorded pH exceedances (7.6 and 7.7) are therefore considered to be within the range of the natural variations at this location.
It is also noted from AFCD's Environmental Management of Pond Fish Culture (EMPFC) guidelines from its Series of Good Aquaculture Practice that the pH level of fishpond water should be between 6 and 8.5. The recorded values were well within the guideline recommendations. Nevertheless, aerators were observed on the days of pH exceedance (see Photo 1 to 4). Aerators help reduce alkalinity and remove excess carbon dioxide, thus improving water quality and stabilizing pH levels.
It is concluded that the pH exceedances at MP3 were possibly due to localised natural variations and external factors such as pond fish culture activities in the fish pond represented by MP3, which are not related to project construction activities.
Exceedances of DO at MP6
Exceedances of the Limit Level of DO were observed on 14, 16 and 18 November 2022 at MP6.
On the days of DO exceedance at MP6, some reed growth was observed along the ditch near the water sampling point at MP6 (see Photos 5 to 7). It is possible that such vegetation growth and its degradation may have led to a decrease in the DO level in the water at MP6 on the days of DO exceedance.
As observed from the observatory records for the month of November 2022, the total bright sunshine hours were particularly high for the day before the DO exceedances (i.e., 13 November 2022), with generally fine weather. On the days of DO exceedance, though the weather was mainly cloudy, there were also sunny periods during the day. On sunny days, photosynthesis of algae sometimes increases the DO sharply in the water. As algae grows further and dies, it may lead to a decrease in DO in the water.
Furthermore, the site effluent was effectively treated by the AquaSed system and discharged from the site at a low, controlled rate during the reporting month.
It is also noted that no DO exceedance was detected downstream at MP4 and MP5 and therefore this exceedance is regarded as a result of a localised natural variation due to the growth of reed near the sampling point at MP6.
Conclusion
As a result, the abovementioned exceedances were unlikely to be due to the project construction works and therefore not considered to be related to the project.
Appearance of the water body at MP3 on 2 November 2022 |
||
|
|
|
Appearance of the water body at MP3 on 4 November 2022 |
||
|
|
|
Photo 3 |
Appearance of the water body at MP3 on 7 November 2022 |
|
|
|
|
Photo 4 |
Appearance of the water body at MP3 on 9 November 2022 |
|
|
|
|
Photo 5 |
Appearance of the water body at MP6 on 14 November 2022 |
|
|
|
|
Photo 6 |
Appearance of the water body at MP6 on 16 November 2022 |
|
|
|
|
Photo 7 |
Appearance of the water body at MP6 on 18 November 2022 |
|
|
|
|
This report documents surveys conducted in the Survey Area between 1 and 30 November 2022. The Wetland Restoration Area (WRA) is also surveyed as the area is accessible and site formation works for WRA has been completed. The updated survey transect is provided in Figure 4.1. Dates and ecological surveys conducted during this period are summarised in Appendix H.
Monitoring was undertaken following the survey methodology in the EM&A Manual. A transect was followed in the bird surveys (see Figure 4.1). All bird species were identified to species and all bird species of conservation importance and/or wetland dependent were enumerated and recorded to the habitats in which they were observed. Flying birds were not recorded unless they were foraging and/or associated with the habitat (such as swifts, swallows and birds of prey). Further, notable bird observations during other surveys or site inspections were also recorded.
Bird surveys were conducted on a weekly basis. A total of 61 bird species were recorded in the Survey Area (excluding the WRA), 32 of which were species of conservation importance and/or wetland-dependence. Within the WRA, 53 bird species were recorded, 22 of which were species of conservation importance and/or wetland-dependence including two of the three target species (Little Egret and Chinese Pond Heron).
The WRA continues to attract a number of species of conservation importance, including Little Grebe (Tachybaptus ruficollis), Great Cormorant (Phalacrocorax carbo), Grey Heron (Ardea cinerea), Great Egret (Ardea alba), Little Egret (Egretta garzetta), Chinese Pond Heron (Ardeola bacchus), Yellow Bittern (Ixobrychus sinensis), Black-crowned Night Heron (Nycticorax nycticorax), Black Kite (Milvus migrans), Zitting Cisticola (Cisticola juncidis), Chinese Penduline-Tit (Remiz consobrinus), Red-billed Starling (Spodiopsar sericeus), White-cheeked Starling (Spodiopsar cineraceus) and Collared Crow (Corvus torquatus). Little Grebe, Yellow Bittern, Black-crowned Night Heron, Zitting Cisticola and Collared Crow are listed by Fellowes et al. as of “Local Concern” in 2002. Great Cormorant, Grey Heron, Great Egret, Little Egret, Chinese Pond Heron and White-cheeked Starling are listed by Fellowes et al. as of “Potential Regional Concern” in 2002. Black Kite and Chinese Penduline-Tit are listed by Fellowes et al. as of “Regional Concern” in 2002. Red-billed Starling is listed by Fellowes et al. as of “Global Concern” in 2002. However, since publication, the global population of the Red-billed Starling estimate has been revised and the species is now not considered globally threatened. A listing of Regional Concern (RC) based on the importance of the large roosts present near Deep Bay, is more appropriate (Wetland Restoration Plan, Mott, 2008). Red-billed Starling is now listed as Least Concern by IUCN. (IUCN, 2016).
A summary of survey data is provided in Appendix I.
One daytime herpetofauna survey was scheduled in the reporting month. No amphibian species nor reptile species were recorded in the Survey Area (excluding the WRA) nor the WRA during regular or outside regular surveys.
A summary of the survey findings is provided in Appendix J.
One odonates and butterflies survey was scheduled in the reporting month. Nine odonate species and 12 butterfly species were recorded in the Survey Area (excluding the WRA) during regular surveys. Within the WRA, 14 odonate species and 20 butterfly species were recorded during regular surveys. Among the odonates recorded within the WRA, Scarlet Basker (Urothemis signata signata) was listed by Fellowes et al. as of “Local Concern” in 2002.
A summary of the survey findings is provided in Appendix J.
Monitoring of mammals was conducted concurrently with other faunal surveys. Any mammal species encountered during site inspections or other habitat management works were recorded as ‘outside survey’.
No mammal species were recorded in the Survey Area (excluding the WRA) nor within the WRA during regular or outside regular surveys.
A summary of the survey findings is provided in Appendix J.
Regular water level monitoring was conducted on 3 November 2022. Additional water level monitoring was conducted on 26 November 2022, due to continuous rain over that week.
The water levels in the reporting month ranged between 155 and 200cm during the water level monitoring works.
The water level of the Cells allowed wetland birds to use them as foraging sites and attracted diving birds such as Little Grebe (Tachybaptus ruficollis) and Great Cormorant (Phalacrocorax carbo) to forage. The shallower areas along the edges of ponds and islets attracted ardeids such as Great Egret (Ardea alba), as well as the target species Little Egret (Egretta garzetta) and Chinese Pond Heron (Ardeola bacchus). These areas were also used by other wetland-dependent birds as foraging and/or perching sites, such as the White-breasted Waterhen (Amaurornis phoenicurus) and Common Snipe (Gallinago gallinago). The current water level will be kept for wetland bird usage.
In-situ water quality monitoring of all other parameters was conducted on 18 November 2022.
Monitoring data is presented in Appendix K. Locations for the monitoring of water quality for the ecological monitoring are shown in Figure 4.2.
Vegetation management activities undertaken at the site primarily involved removal of excess grass, exotic species and climbers. The exotic Leucaena leucocephala along the EVA and along the Cell bunds were cut down and the branches were piled up for the attraction of herpetofauna.
Climbers were cleared along the emergency vehicular access (EVA) of Cell 1. The cleared climbers were left to dry along the EVA and will be subsequently removed. Weeding works were conducted along the EVA of pond bunds of Cell 1, Cell Cell 3 and Cell 4 and pond bunds between Cell 1 and Cell 2, Cell 2 and Cell 3, Cell 3 and 4. Fallen leaves along the EVA of Cell 3 and Cell 4 were swept aside and formed piles of plant materials on both sides of the EVA. These piles were used to attract herpetofauna.
Excessive vegetation in and around the fish-free pond at the end of the bund between Cell 1 and Cell 2, Cell 2 and Cell 3, and Cell 3 and Cell 4 were cleared.
The vegetations of Cell 1 and Cell 4 provided foraging and roosting habitats for breeding and/or migratory birds, as well as nectar sources for butterflies and rooting sites of dragonflies. Pruning will be kept to a minimum as long as the branches do not block the passage.
Red Imported Fire Ant nests along the cell bunds and along the EVA were checked and marked. Treatments will be conducted in the coming months after the clearance of ground vegetations.
Egg masses of Apple Snails (Pomacea canaliculate) found along concrete structures of the WRA (e.g. sluice gates between Cells, and concrete wall of Cell 4) were cleared.
Mitigation actions have been taken in the WRA during the survey period to increase the WRA utilization by birds, including:
1. Controlling the vegetation at Cell 1, Cell 2, Cell 3 and Cell 4; and
2. Controlling the water level at Cell 1, Cell 2, Cell 3 and Cell 4.
Ecological monitoring during November 2022 was carried out according to the survey methodology and frequency outlined in the EM&A Manual.
A summary of the survey findings is listed in Table 4.1:
Table 4.1: Summary of Ecological Monitoring in WRA and Survey Area under EM&A Manual
Species |
Survey Area (excluding WRA) |
WRA |
Birds (total) |
61 |
53 |
Birds (of conservation importance and/or wetland-dependence) |
32 |
22 |
Amphibians |
0 |
0 |
Reptiles |
0 |
0 |
Mammals |
0 |
0 |
Odonates |
9 |
14 |
Butterflies |
12 |
20 |
Survey findings indicate that the ponds within the Survey Area supported numbers and diversity of wetland-dependent birds typical of fishpond areas. The WRA continues to attract wetland dependent fauna and serves as a buffer between the residential portion and the fishponds in the north.
Two of the three target species, Little Egret (Egretta garzetta) and Chinese Pond Heron (Ardeola bacchus), were observed perching on tall trees or foraging along the shallow water areas within the WRA.
Dense and tall vegetation along the edge of the EVA attracted insectivorous birds such as Yellow-bellied Prinia (Prinia flaviventris) and Plain Prinia (Prinia inornata). Passerines such as Light-vented Bulbul (Pycnonotus sinensis), Red-whiskered Bulbul (Pycnonotus jocosus), Oriental Magpie Robin (Copsychus saularis), Cinereous Tit (Parus cinereus), Swinhoe’s White-eye (Zosterops simplex), Masked Laughingthrush (Garrulax perspicillatus), Common Tailorbird (Orthotomus sutorius), Asian Brown Flycatcher (Muscicapa latirostris) and Black-collared Starling (Gracupica nigricollis) were observed foraging among the vegetations. These vegetations were also used by butterflies and odonates as perching sites. The vegetation stands will be kept provided that the branches do not overgrow and obscure the EVA. During vegetation clearance, some of these environments were treated with only minimum trimming to preserve suitable habitats for wildlife.
The reedbed of the WRA is used by prinias as well as reed-dependent migrant Black-browed Reed Warbler (Acrocephalus bistrigiceps) and Stejneger's Stonechat (Saxicola stejnegeri) as foraging site. Reed-dependent Yellow Bittern (Ixobrychus sinensis) was also recorded roosting in the reedbed. The reedbed will be closely monitored before conducting any clearance work.
Fallen leaves scattered along the EVA were swept aside and formed a thicker layer of fallen plant materials. These piled-up plant materials are used to attract amphibians and reptiles within the WRA.
The EM&A programme for Landscape and Visual impact due to the construction commenced in June 2010 and continued during the reporting period. Site inspections on Landscape and Visual impact were carried out on 4 and 16 November 2022 to confirm the implementation of mitigation measures at the construction stage.
The Event and Action Plan for Landscape & Visual is shown in Appendix D.
The audit was undertaken with reference to the specific checklists provided in Table 2.13 – Table 2.15 and audit results are summarized below in Table 5.1. Representative photos showing the implementation of mitigation measures are presented in Appendix M.
Table 5.1: Construction and Operation Phase Audit Summary
Area of Works |
Items of be Monitored |
Works Area |
The boundaries of the works area have been established on site in accordance with the contract documents and approved plans (EP), and the limit of current heavy construction activity is now confined to within the site hoardings (North side of the site / access road) and the noise barriers (other sides of the site). Minor works such as horticultural maintenance of the planting and transplanted trees, and boundary fence repair was proceeding along the Royal Palms – Palm Springs boundary. (Appendix M Photo 1 – Table 2.14 CM2 refers) No construction works were observed to have exceeded the site boundaries. No construction was carried out at the wetland restoration area after 15 November 2010. |
Protection of all trees and woodland blocks to be retained |
Trees retained within the site along the northeast boundary, beside wetland restoration area, have been identified and protected by temporary protective fencing. |
Streams |
The works site is partly encircled by a berm / perimeter channel to intercept surface water and prevent it from washing off into any of the neighbouring sites. Surface water is collected within the site in a temporary drainage channel. Gravels beds and barriers have been installed to filter site runoff, sedimentation ponds have been provided to enable primary treatment before discharge to mains drains. |
Clearance of existing vegetation |
Site clearance was completed prior to the commencement of construction. |
Transplanting of trees |
Tree transplanting has been completed, with the trees relocated to various points within the planting strip along the southern boundary of the site, outside the noise barrier. Most of the trees continue to re-establish well. One tree (i.e., tree no. A34) was observed to have poor health condition. Regular watering and close monitoring of this tree is recommended. |
Topsoil stripping |
Suitable pond bund and soil material which had been excavated and stockpiled from the original site, has now been re-used within the landscape works. Dust suppression measures are active along all internal site access tracks. |
New buildings |
No new permanent buildings have yet been constructed on site. |
Boundaries |
Hoardings have been erected along most of the boundaries of the site. Installation of new screen fence between the future residential sites and the constructed wetland restoration areas is complete. Fence has been painted green to match with the surrounding vegetated environment. (Appendix M Photo 1 – Table 2.14 CM2 refers) |
Noise Barrier |
Noise barriers have been installed along the southern and western boundaries of the site in accordance with the contract requirements. Their design complies with the mitigation requirements, with upper 6 to 7m portion of the barrier being made from a translucent material with green tinted (to match with the environment). Supporting GMS structure, likewise, has been painted green. (Appendix M Photo 3 – Table 2.14 CM6 refers). |
Night-time lighting |
No night-time works were reported to have been carried out during the monitoring period. |
Landscape and wetland treatments generally |
Continuous belt of screen planting along the southern and western boundaries of the site has been completed. The formation, soiling and water control structures of the wetland restoration area have been completed. (Appendix M Photo 3 – Table 2.14 CM6 refers) The wetland areas have been established, with the ponds are being seasonally filled with rainwater. Planting of areas around the WRA cells is complete. No construction was carried out at the wetland restoration area after 15 November 2010. (Appendix M Photo 2 – Table 2.14 CM2 refers) |
Soiling, etc. |
The soil placement and grading for each of the wetland restoration areas has been completed. Refilling for those holes left after the whole tree removal works has been completed. |
Plant supply |
The plant material used in the Advance Planting Strip and in the WRA are all commonly available species and came from commercial sources. Transplanted reeds (Phragmites australis) at the wetland habitat came from the temporary holding nursery onsite. |
Planting |
The tree species are all from the approved list. Seedling trees and shrubs have been established at the margins of the wetland cells. Some invasive species and undesirable exotic species have been found during site inspection, removal of these species should be undertaken on a regular basis. |
Establishment Works |
The advance planting, the compensatory planting and transplanted trees are generally being maintained by the landscape sub-contractor in accordance with the specification to ensure that the contract requirements are met. Presence of termites was observed on some trees (tree no. 389 & 393) and application of pesticides is recommended. Removal of overgrown weeds, unplanned tree seedlings and invasive climbers in the space behind screen noise barrier needs to be undertaken on a monthly basis as they may inhibit the advance planting. Regular removal of invasive species (i.e. apple snails, Leucaena leucocephala, Mikania micrantha, Mimosa pudica, Bidens alba, Ludwigia erecta, Sesbania cannabina, etc.) in WRA should be undertaken. Red imported fire ant nests were observed along the passageway. It is recommended to eradicate all ant nests in the early dry season to prevent spreading. The growth of shrubs / seedlings on the north side of the WRA remains fair. |
The ET had carried out construction phase weekly site inspections on 4, 11, 16 and 24 November 2022. All observations have been recorded in the site inspection checklist and passed to the Contractor together with the appropriate recommended mitigation measures where necessary. The key observations from site inspections and associated recommendations are summarized in Table 6.1.
Table 6.1: Summary of Site Inspections and Recommendations
Key Observations |
ET Recommendation |
Contractor’s Responses / Action(s) Undertaken |
Close-out (Date) |
Nil |
|
|
|
The Contractor has been registered as a chemical waste producer for the Project. Construction and demolition (C&D) material sorting was carried out on site. A sufficient number of receptacles were available for general refuse collection.
As advised by the Contractor, no inert C&D material (i.e. broken concrete/ big boulders) were generated on site and sent to a sorting facility for recycling into rockfill. No metals were generated and collected by registered recycling collector. No paper/cardboard packing and no plastics were generated on site and collected by registered recycling collector. No chemical waste was generated and collected by licensed chemical waste collector. No other types of wastes (e.g. general refuse) were generated on site and disposed of at public landfill facility.
The Contractor is advised to maintain on site waste sorting and recording system and maximize reuse / recycling of C&D wastes, whenever these are generated.
The environmental permits, licences, and/or notifications on environmental protection for this Project which were valid during the reporting period is summarised in Table 6.2.
Table 6.2: Status of Environmental Submissions, Licences and Permits
Statutory Reference |
Description |
Permit/Reference No. |
Status |
EIAO |
Environmental Permit |
EP-311/2008/E |
Valid |
APCO |
Notification of Construction Work under APCO |
2018-027-A-1 (20 July 2020) |
Valid |
WPCO |
Discharge Licence |
WT00037436-2021 (21 Apr 2021) |
Valid |
WDO |
Registration as Chemical Waste Producer |
WPN0000-542-H3083-04 |
Valid |
WDO |
Bill Account for Disposal |
700945423 |
Valid |
Legend: EIAO – Environmental Impact Assessment Ordinance; APCO – Air Pollution Control Ordinance; WPCO –Water Pollution Control Ordinance; WDO – Waste Disposal Ordinance
The EM&A programme followed the recommended mitigation measures in the EM&A Manual. The EM&A requirements as well as the summary of implementation status of the environmental mitigation measures are provided in Appendix L. In particular, the following mitigation measures continue to be implemented at the site:
Air Quality
● Access roads should be sprayed with water or dust suppression chemical to maintain the entire road surface wet or paved.
Water Quality
● Site effluent should be discharged in accordance with the discharge licence.
● The site should be confined and properly maintained to avoid silt runoff.
● Chemicals will always be stored on drip trays or in bunded areas.
Waste Management
● The chemical waste storage area should be clearly labelled.
● General refuse should be stored in enclosed bins or compaction units separate from C&D and chemical wastes.
There was no breach of Action or Limit Levels for Air Quality and Noise monitoring in the reporting month.
A summary is presented in Table 7.1 below.
Table 7.1: Summary of Exceedances in Water Quality
Monitoring Date |
pH |
Dissolved Oxygen (DO) (mg/L) |
Turbidity (NTU) |
Suspended Solids (mg/L) |
MP3 |
|
|
|
|
02/11/2022 |
7.7 |
7.4 |
40.3 |
43 |
04/11/2022 |
7.6 |
7.8 |
10.3 |
7 |
07/11/2022 |
7.7 |
7.6 |
8.1 |
8 |
09/11/2022 |
7.6 |
7.7 |
40.3 |
41 |
Action Level |
<5.5 or >7.5 |
<6.85 |
>64 |
>65 |
Limit Level |
<4.0 or >8.0 |
<6.65 |
>67 |
>66 |
MP6 |
|
|
|
|
14/11/2022 |
6.9 |
4.5 |
21.3 |
29 |
16/11/2022 |
6.8 |
4.3 |
30.0 |
33 |
18/11/2022 |
6.8 |
4.4 |
26.9 |
49 |
Action Level |
<5.5 or >7.5 |
<4.61 |
>94 |
>75 |
Limit Level |
<4.0 or >8.0 |
<4.52 |
>96 |
>75 |
Notes:
(1) “<2”: Value is too low to indicate (<2mg/L).
(2) For the Limit Level of DO, 1-percentile of baseline data is adopted as it is greater than 2mg/L. (Refer to Baseline Monitoring Report)
(3) Values in Bold indicate Action Level exceedance.
(4) Values Underlined and in Bold indicate Limit Level exceedance.
No environmental complaint was received during the reporting month.
No notifications of summons or successful prosecution were received the reporting month.
Non-compliance
Investigations have been carried out to identify the causes of the water quality exceedances.
The investigation findings are presented in Section 3.2.3.1. It was concluded that the abovementioned exceedances were unlikely to be due to the construction works and therefore not considered to be related to the project.
Complaints, Summons and Prosecutions
Not applicable for this reporting month.
Non-compliance
The Event and Action Plan has been followed. Although it is considered that the exceedances were not related to the Project, the Contractor was reminded to implement the water quality mitigation measures in accordance with the recommendation stated in Section 5.6.1 – 5.6.4 of the EIA Report as far as practicable, regular spot checks would be conducted on the nearby discharge by the Contractor and he would inform the ET for investigation.
Complaints, Summons and Prosecutions
Not applicable for this reporting month.
Cumulative statistics for complaints, notifications of summons and successful prosecutions for the Project account for period starting from the date of commencement of construction (i.e., 12 May 2010) to the end of the reporting month and are summarized in Table 7.2 below.
Table 7.2: Statistics for Complaints, Notifications of Summons and Successful Prosecution
Reporting Period |
Cumulative Statistics |
||
Complaints |
Notifications of Summons |
Successful Prosecutions |
|
This reporting month (November 2022) |
0 |
0 |
0 |
From 12 May 2010 to end of the reporting month (November 2022) |
8 |
0 |
0 |
Site works to be commissioned in the coming month include:
● Regular maintenance work for the Wetland Restoration Area (including adjusting the water level, if required, and removal of unwanted species in the pond)
● No major construction works
Key issues to be considered in the coming three months include:
● Provision of water spraying or dust suppression chemical to prevent generation of dust from activities on-site and the haul road during dry weather conditions;
● Provision of wheel washing facilities at vehicle exit point;
● Generation and treatment of site surface runoffs and wastewater from activities on-site and during wet weather conditions;
● Sorting, recycling, storage and disposal of general refuse and construction waste from activities on-site; and
● Management of chemicals and avoidance of oil spillage on-site and to the drainage system.
The environmental site inspection and environmental monitoring will be continued in the coming month. Impact monitoring for air, noise, water quality, ecology and landscape and visual in accordance with the approved EM&A Manual has commenced since 12 May 2010. The tentative monitoring schedule for December 2022 is shown in the Table 8.1.

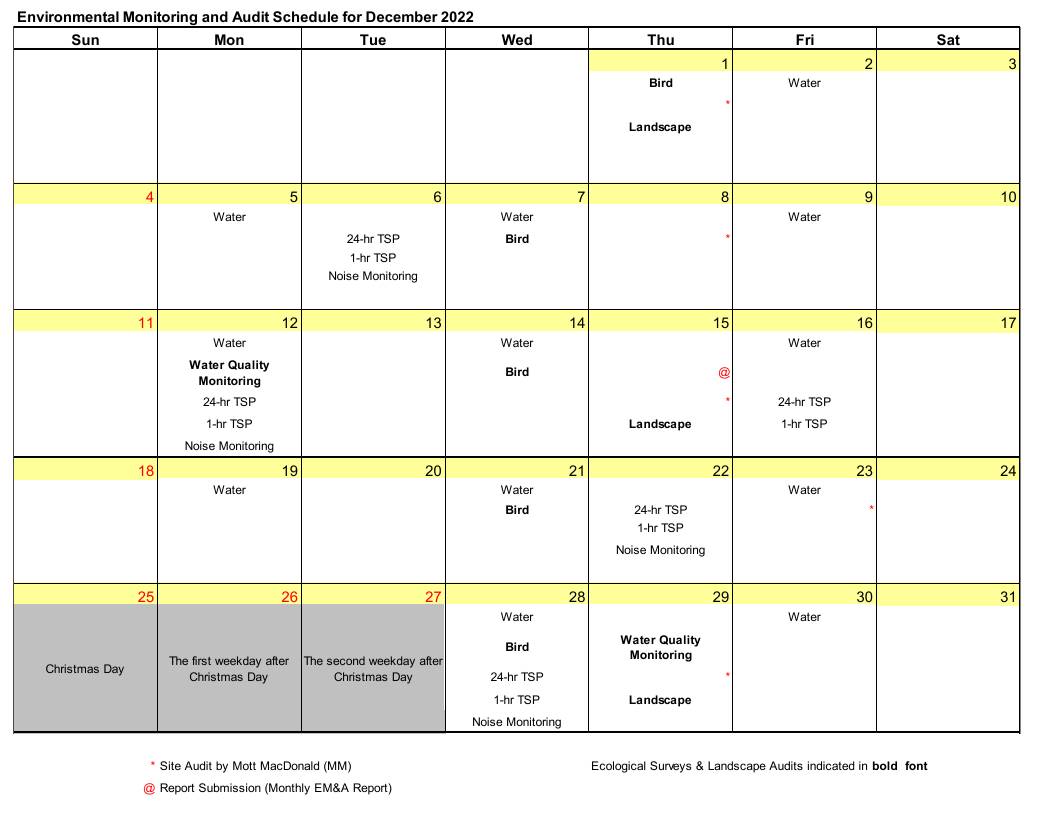

Table 8.1: Tentative Environmental Monitoring and Audit Schedule for the Next Reporting Month
The EM&A programme as recommended in the EM&A manual has been undertaken in the reporting month since 12 May 2010.
Monitoring of Air Quality, Noise, Water Quality, Ecology and Landscape and Visual impacts due to the Project was under way. In particular, the 1-hr TSP, 24-hr TSP, noise level (as Leq) and water quality parameters (such as pH, DO, turbidity and SS) under monitoring have been checked against established Action and Limit levels.
There was no breach of Action or Limit Levels for Air Quality and Noise monitoring in the reporting month.
During November 2022, a total of four Action Level exceedances and three Limit Level exceedances for Water Quality were observed. Four Action Level exceedances of pH were recorded at MP3. Three Limit Level exceedances of DO were recorded at MP6.
With considerations on the construction activities and environment, the following recommendations were provided:
Air Quality
● All stockpiles should be covered by tarpaulin or kept wet by water spraying;
● All vehicles should be washed to remove any dusty materials before leaving the construction sites;
● The portion of road leading the construction site that is within 30m of a designated vehicle entrance or exit should be kept clear of dusty materials;
● During the dry season, sufficient water spraying should be provided at haul road to reduce dust emission; and
● Ensure proper functioning of the wheel wash facility.
Noise
● Mobile plant should be sited as far away from NSRs as possible;
● Plant known to emit noise strongly in one direction should be orientated to direct noise away from the NSRs; and
● The construction activities should be better scheduled to reduce noise nuisance.
Water Quality
● Effluent should be discharged in accordance with the discharge licence conditions;
● Soil contaminated with chemicals/oils should be removed from site and the voids should be created filled with suitable materials; and
● Silt and debris should be removed from the temporary drainage channel regularly.
Waste Management
● General refuse should be stored in enclosed bins or compaction units separate from C&D and chemical wastes to minimise odour, pest and litter impacts.
● Reuse the excavated materials as far as practical to reduce the amount of waste disposal;
● C&D waste should be segregated and stored in different containers to other wastes to encourage the re-use or recycling of materials and their proper disposal;
● Ensure drip trays are provided for chemical containers to prevent leakage or soil contamination;
● All plants and vehicles should be properly maintained to prevent oil leakage; and
● Oil stains on soil should be cleared by disposal of contaminated soil.
Agriculture, Fisheries and Conservation Department. 2019. Hong Kong Biodiversity Database. https://www.afcd.gov.hk/english/conservation/hkbiodiversity/database/popup_record.php?id=748, 2019 -07-09
BirdLife International. 2017. Important Bird Areas factsheet: Inner Deep Bay and Shenzhen River catchment area. <http://www.birdlife.org> on 06/07/2017.
Carey, G. J., Chalmers, M. L., Diskin, D. A., Kennerley, P. R., Leader, P. J., Leven, M. R., Lewthwaite, R. W., Melville, D. S., Turnbull, M., and Young, L. 2001. The Avifauna of Hong Kong. Hong Kong Bird Watching Society, Hong Kong.
Chan, S.K.F., K.S. Cheung, C.Y. Ho, F.N Lam & W.S. Tam, 2005. A Field Guide to the Amphibians of Hong Kong. Cosmos Books Ltd., Hong Kong.
Fellowes, J.F., M.W.N. Lau, D. Dudgeon, G.T. Reels, G.W.J. Ades, G.J. Carey, B.P.L. Chan, R.C. Kendrick, K.S. Lee, M.R. Leven, K.D.P. Wilson, Y.T. Yu, 2002.Wild Animals to Watch: Terrestrial and Freshwater Fauna of Conservation Concern in Hong Kong. Hong Kong.
Hong Kong Bird Watching Society 2020. List of Hong Kong Birds - 2020-03. <www.hkbws.org.hk>.
Hong Kong Observatory Climate Information Service. <https://www.hko.gov.hk/en/wxinfo/pastwx/mws/mws.htm>
Horiuchi, S., Odawara, T., Yonemura, S., Hayashi, Y., Kawaguchi, M., Asada, M., Kato, M. & Yasuhara, K. (2007, November). Floating structure using waste tires for water environmental remediation. In Scrap Tire Derived Geomaterials-Opportunities and Challenges: Proceedings of the International Workshop IW-TDGM 2007. p. 291. CRC Press.
IUCN 2016. IUCN Red List of Threatened Species. Version 2016-3. <www.iucnredlist.org>. Downloaded on 7th December 2016
Karsen, S., M.W.N. Lau & A. Bogadek, 1998. Hong Kong Amphibians and Reptiles. Provisional Urban Council, Hong Kong.
List of National Protected Animal (updated on 5 Feb 2021) http://www.gov.cn/xinwen/2021-02/09/5586227/files/e007df5cdb364bcdbcb89d169047d6c5.pdf
Lo, P. Y. F. and W.L. Hui, 2004. Hong Kong Butterflies. Hong Kong, Cosmos Books Ltd.
Mott, 2008. WSW Environmental Monitoring and Audit Manual (March 2008).
Mott, 2008. WSW Environmental Impact Assessment Report Volumes 1 to 3 (March 2008).
Mott, 2008. WSW Wetland Restoration Plan (March 2008).
Shek, C. T. 2006. A Field Guide to the Terrestrial Mammals of Hong Kong. Friends of the Country Parks Cosmos Books Ltd., Hong Kong.
Tam, T.W., K.K. Leung, B.S.P. Kwan, K.K.Y. Wu, S.S.H. Tang, I.W.Y. So, J.C.Y. Cheng, E.F.M. Yuen, Y.M. Tsang, and W.L. Hui, 2011. The Dragonflies of Hong Kong (1st edition). Agriculture, Fisheries and Conservation Department, Friends of Country Parks and Cosmos Books Ltd., Hong Kong.
Wilson, K.D.P., Tam, T.W., Kwan, B.S.P., Wu, K.K.Y., Wong, B.S.F., Wong J.K. 2004. Field Guide to the Dragonflies of Hong Kong. AFCD, Friends of Country Park and Cosmos Books Ltd. Hong Kong.
Young, J.J. & Yiu, V., 2002. Butterfly Watching in Hong Kong. Wan Li Book Co. Ltd., Hong Kong.
Zheng Guangmei and Wang Qishan (1998) (Edited), China Red Data Book of Endangered Animals: Aves, Science Press, Beijing.
